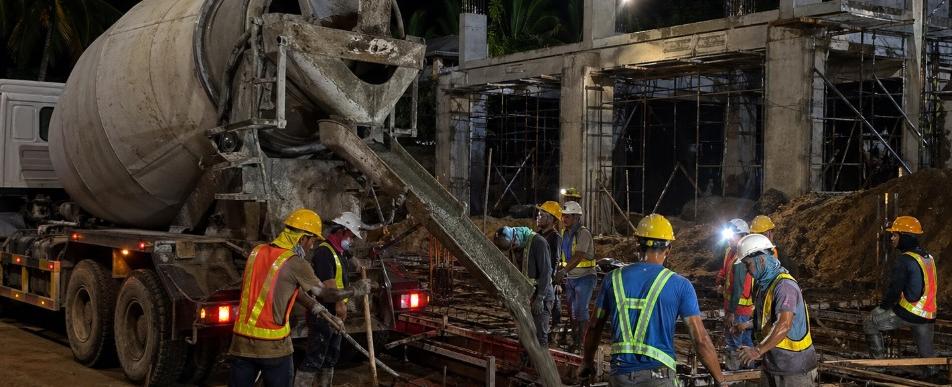

Pouring Concrete in Cebu Heat: Why I Ended Up Doing a 9 PM Pour at 4500 PSI

By Daniel Sobrado
Published in Structures
March 01, 2026
5 min read
Pouring Concrete in Cebu Heat: Why I Ended Up Doing a 9 PM Pour at 4500 PSI

Concrete in Tropical Heat: Subdivision Rules vs ACI 305

Hey, Daniel here!

Quick one but an important one. When you build in a Philippine subdivision, the rules are written for noise control, not for structural engineering. Those two priorities collide hard the day you have to pour concrete.

Here’s what I ran into in Cebu, and what I ended up doing about it.

The Problem

My subdivision only allows heavy equipment entry from 9:00 AM to 5:00 PM. By 9 AM ambient temperature in Cebu is already 27-28°C and rising fast. By noon it’s 33-35°C in the shade and the sun is hammering the formwork.

Now look at what ACI 305 (the international standard for hot weather concreting) says: maximum concrete temperature at placement: 35°C. Concrete leaves the local batching plant at 35-36°C already. By the time you set up the pump after 9 AM and start placing, that concrete has been sitting in the truck and pump line getting hotter.

For a 3,500 PSI residential pour, this is the difference between concrete that lasts 50 years and concrete that starts cracking and spalling at 15. Higher placement temperatures mean:

  • Faster initial set (less working time)
  • Higher water demand
  • More plastic shrinkage cracking
  • More porous, less dense final product
  • Lower long-term strength (10-20% loss is realistic at 38°C+)
  • Reduced chloride resistance (huge issue near the coast)

In a country where the structure also needs to survive typhoons and earthquakes for decades, that strength loss is not academic.

The Options I Looked At

I went through all four of these:

1. Early morning pour (5:30-6:00 AM entry)

Best concrete temperatures, but needs special subdivision approval and overtime fees. Most subdivisions just say no on principle because of noise.

2. Night pour (7:00 PM onwards)

Coolest temperatures, but you fight noise complaints, lighting cost, and harder visual QC. Needs subdivision approval too.

3. Pour within allowed hours (9 AM+)

Easiest path. Worst possible outcome for the concrete. This is the default a lot of homeowners accept without realizing what they’re agreeing to.

4. Chilled water / ice in the mix

One Cebu supplier quoted ₱1,500/m³ surcharge on top of about ₱5,000/m³ base. So roughly +30% to drop placement temp 5-10°C. Effective, but expensive.

What I Actually Did

After running the numbers and asking around, here’s what I landed on:

Night pour at 9 PM, approved by the subdivision, with the concrete bumped from 3,500 PSI to 4,500 PSI.

Two key things had to happen:

1. Got Subdivision Approval for a Night Pour

I went door-to-door to my immediate neighbors first, explained what was happening, told them roughly how long it would take, and got verbal permission. Then went to the HOA with that in hand. It’s much harder for an HOA to block a pour when you’ve already cleared it with the neighbors who would actually complain.

2. Bumped the Concrete Spec from 3,500 to 4,500 PSI

Cost difference: about ₱500 per cubic meter. Real money on a big pour, but compare it to:

  • Ice/chilled concrete: +₱1,500/m³
  • Retarding admixture only: +₱370-1,320/m³
  • Repair after weak concrete: ₱150,000-500,000+ later

A 38°C placement gives roughly 20% strength reduction. Going from 3,500 PSI to 4,500 PSI gives you back about that much margin and then some, even before factoring in the temperature benefit of pouring at night.

So I’m hitting it from two directions: lower placement temperature (night pour) and higher mix design.

The Cost Comparison Table

This is the rough trade-off picture I worked from for Cebu coastal conditions:

ApproachAdded cost (10 m³)BenefitRisk if skipped
Early morning pour (4-5 AM)₱650-1,150Placement at 28-32°C vs 35-40°C10-15% permanent strength loss
Ice/chilled concrete₱2,000-5,000Up to 12°C reductionRapid setting, poor consolidation
Retarding admixture₱370-1,320Extends working time 1-3 hrsPremature setting, cold joints
Marine-grade concrete (5,000 vs 3,000 PSI)₱6,430Reduced porosity, chloride resistancePremature corrosion (10-15 yr vs 50+ yr)
Proper 7-day wet curing (100 m² slab)₱8,000-16,000Optimal strength developmentUp to 40% strength loss
Standard daytime pour, no precautions₱0NoneRepair costs ₱150,000-500,000+

The optimal combo for coastal Cebu (early morning or night start, retarding admixture, chilled water if needed, marine-grade concrete, proper curing) adds roughly ₱1,000-2,000 per cubic meter, or a 20-40% premium over the cheapest possible approach. Structural repair of chloride-deteriorated concrete costs 5-10× the original placement cost. Prevention-to-remediation ratio is 10:1 to 25:1.

Retarding admixtures have the highest ROI - under ₱132/m³ for water-reducing retarders (less than 3% of the concrete cost) for 1-3 hours of additional working time. Early morning pour is second-best value. Chilled concrete is the most expensive preventive measure but may be the only option if HOA rules block early or night pours and ambient hits 35°C+.

Verifying It Actually Worked: The Test Reports

Pouring at night and bumping the spec is one thing. Confirming it actually worked is another. We took cylinder samples at the pour and sent them to an independent lab.

Here’s what came back from the ASTM C39 test on the footing pour:

Concrete cylinder compressive strength test report at 28 days

5,694 PSI and 5,718 PSI at 28 days on a 4,500 PSI design mix. That’s about 27% above design strength. At 7 days the same cylinders were already at around 5,200 PSI.

Why so much above the design number? Because the night pour kept placement temperature low (we had a thermistor in the wet concrete to confirm), the curing was done properly, and the mix had margin in it.

Concrete temperature probe readings during the night pour

That probe reading is from the actual pour - readings sitting comfortably in the safe range, well below the ACI 305 ceiling. Compare that to a noon pour in March in Cebu with concrete arriving at 35-36°C and getting hotter.

What I’d Tell Other Homeowners

  1. Read your subdivision rules before scheduling any pour. Don’t assume the pump truck can show up at sunrise.
  2. If your only option is daytime, fight for early morning instead of midday. Even a 4-5 AM start beats 10 AM hands down on concrete temperature.
  3. If neither early nor night is allowed, get the chilled water surcharge in writing and budget for it. It’s not optional in Cebu/coastal conditions.
  4. Going from 3,500 to 4,500 PSI is cheap insurance. Roughly ₱500/m³. It’s often the simplest single change with the biggest payoff.
  5. Always cylinder-sample your pour and send to an independent lab. Don’t rely on the supplier’s own numbers. ASTM C39 break tests at 7 and 28 days are the only honest way to know what you actually got.
  6. Cure properly. Up to 40% of the strength gain is in the curing, not the mixing. 7 days minimum of wet/covered curing in our climate.

Bottom Line

Subdivision rules are written for noise. Concrete is structural. When those collide, you have to push for an exception or pay to compensate.

For me, the math worked out as: night pour + 4,500 PSI + proper curing + lab-verified cylinders. Total premium on the build was small. Result was footings testing at 5,700 PSI at 28 days, which buys me a lot of typhoon-and-earthquake margin for a tropical, coastal-influenced site.

If you’re about to pour and your only plan is “concrete truck shows up at 10 AM and we’ll figure it out,” stop. There are better options and most of them cost less than fixing it later.


Curious to hear from anyone else in Cebu - who’s your ready-mix supplier, what are you paying per cubic, and did your subdivision allow early or night pours? Always interested in real numbers.


Tags

#concrete#hot-weather-concreting#cebu#night-pour#aci-305#ready-mix#subdivision-rules#concrete-strength#footings

Share

Previous Article
Construction Update: We Stopped a Concrete Pour and Redid the Footings - 3 Weeks Lost, Headaches Saved
Daniel Sobrado

Daniel Sobrado

I build stuff

Table Of Contents

1
Concrete in Tropical Heat: Subdivision Rules vs ACI 305
2
The Problem
3
The Options I Looked At
4
What I Actually Did
5
The Cost Comparison Table
6
Verifying It Actually Worked: The Test Reports
7
What I'd Tell Other Homeowners
8
Bottom Line
