You’re at the construction site of your villa in Cebu, and the workers have just finished placing the steel reinforcement for your footings. The foreman assures you everything is “okay lang,” but with your family’s safety and investment at stake in this seismic zone, how do you actually verify the reinforcement meets standards?
Critical fact: The Philippines sits in Seismic Zone 4, making proper reinforcement detailing not just important but life-critical. Poor rebar installation has been identified as a primary failure factor in 56% of structural collapses during earthquakes. This guide provides specific, actionable inspection criteria based on the National Structural Code of the Philippines (NSCP 2015) and proven field practices.
Standard sizes for residential footings:
How to verify:
Red flag: Substitution of 10mm bars where 12mm specified reduces strength by 30%. This is a serious violation requiring immediate correction.
NSCP-mandated spacing (Section 407):
Field verification method:
Example from Cebu practice: A 2.2m × 2.2m × 0.4m thick footing typically uses 16mm bars @150mm spacing, providing reinforcement ratio >0.0018 (code minimum).
NSCP requirements for footings cast against earth:
How to check cover:
Common violation: Rebar placed directly on soil with inadequate spacers. This causes premature corrosion and must be corrected before pouring.
Mandatory in Seismic Zone 4 (Cebu):
Verification steps:
For columns at footing interface:
Inspection checklist:
ACCEPTABLE:
REJECT/CLEAN:
Field test: Wire-brush a sample area – if base metal is sound and dimensions within ASTM tolerances, bar is acceptable.
NSCP requirement: Minimum 40 × bar diameter for tension laps
If found short: Reject and replace bars – welding extensions requires special approval and testing.

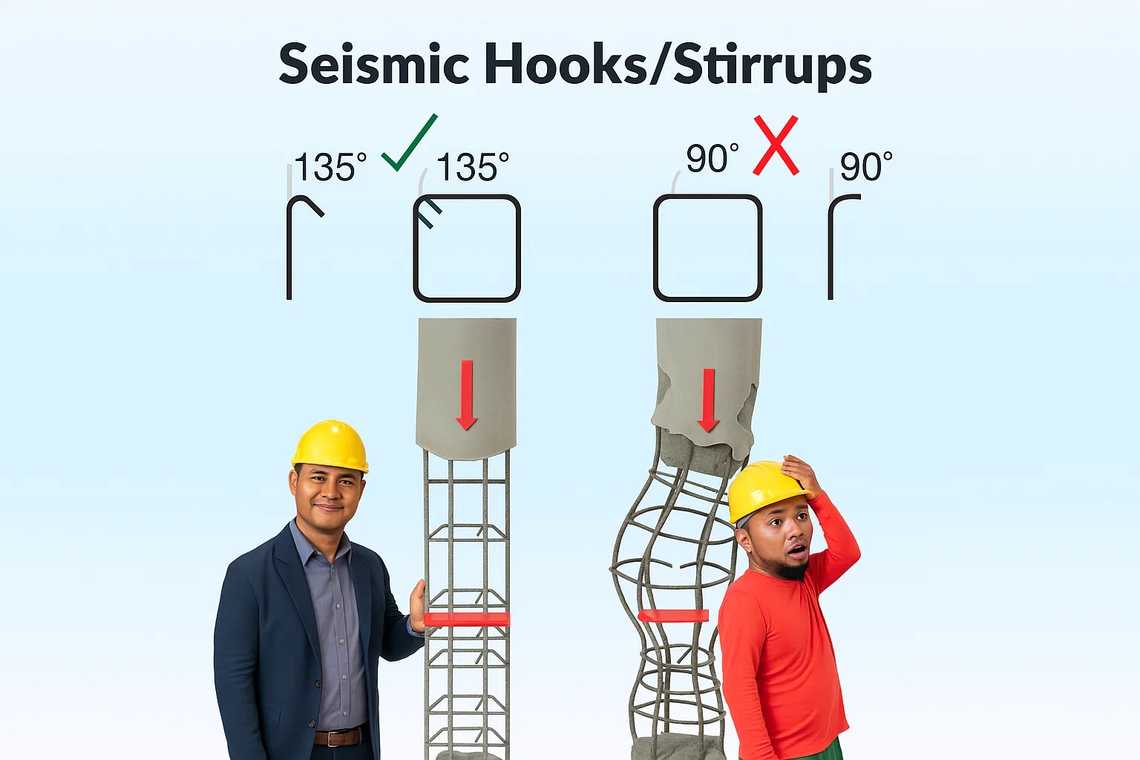

Problem: 90° hooks instead of 135° seismic hooks on stirrups Solution: Rebend on-site if possible, replace if material is compromised
Problem: Hook tails too short (<6db) Solution: Cannot be fixed – replace stirrups
Prevention measures:
Never allow without engineer approval:
1. Document Review (before site visit):
2. Size and Quantity Check:
3. Layout Verification:
4. Cover Confirmation:
5. Connection Details:
6. Material Quality:
7. Stability Check:
Immediately halt concrete pouring if:
Remember: Once concrete is poured, reinforcement errors cannot be corrected. The cost of delay is minimal compared to structural failure or expensive retrofitting.
Real consequences of poor reinforcement:
Investment in proper inspection:
For homeowners:
For contractors:
For inspectors:
Proper reinforcement inspection isn’t just bureaucracy – it’s the difference between a foundation that protects your family for generations and one that fails when tested by nature. In Seismic Zone 4, every hook, every spacing, and every millimeter of cover matters.
The few hours spent verifying reinforcement before concrete placement is the most important quality control investment in your entire project. Use this guide, demand compliance, and document everything. Your future self will thank you when the next earthquake hits and your home stands strong.
Remember: In construction, what you can’t see matters most. Make sure it’s right before it disappears forever into concrete.
